Artificial Turf Installation Timeline: What Homeowners Should Expect

  • March 18, 2026

Installation Timeline: What Homeowners Should Expect | The Short Answer: 2 to 7 Days (For Most Residential Projects) | What Actually Determines the Installation Timeline? | The Artificial Turf Installation Timeline | Where Homeowners Get Misled | The Risk of Rushed Installations | Southern Arizona-Specific Considerations | The Investment Mindset: Time = Quality | Real-World Example (Southern Arizona) | What Homeowners Should Ask Before Installation | Final Thoughts: Don’t Rush the Process

Artificial turf installation process explained

AZsep2

The Artificial Turf Installation Timeline: What Homeowners Should Expect

Why the Installation Timeline Matters More Than You Think

When most homeowners in Southern Arizona start exploring artificial turf, one of the first questions is:

  • “How long does it take to install artificial turf?”
  • It sounds simple, but the real answer is more nuanced.

Artificial turf installation isn’t just about laying grass. It’s a structured construction process - and the timeline directly impacts quality, durability, and long-term performance

 Top
AZsep2

The Short Answer: 2 to 7 Days (For Most Residential Projects)

For a typical residential installation in Southern Arizona:

  • Small projects (500–1,000 sq. ft.): 2–3 days
  • Medium projects (1,000–2,500 sq. ft.): 3–5 days
  • Large or complex projects: 5–7+ days

But here’s the key: Speed should never come at the expense of proper preparation and installation.

 Top
AZsep2

What Actually Determines the Installation Timeline?

Several factors influence how long your project will take.

1. Site Preparation & Existing Landscape Removal

  • Removing natural grass, rock, or old materials
  • Demolition of previous landscaping or irrigation systems
  • Grading and leveling the area

This is often the most labor-intensive phase.

2. Base Construction (The Most Critical Step)

  • Installing and compacting aggregate base
  • Ensuring proper grading and drainage
  • Creating a stable foundation

This step determines whether your turf lasts years - or fails prematurely.

3. Design Complexity

  • Curves, borders, and custom layouts
  • Integration with pavers, concrete, or planters
  • Multiple elevations or slopes

More design detail = more installation time

4. Access to the Project Area

  • Tight spaces or limited equipment access
  • Backyard vs. front yard installations
  • HOA or neighborhood restrictions

5. Weather & Scheduling

  • Extreme heat in Arizona summers
  • Rain (less common, but still a factor)
  • Crew availability and scheduling
 Top
AZsep2

Step-by-Step: The Artificial Turf Installation Timeline

Day 1: Site Prep & Demolition

  • Remove existing grass, weeds, or rock
  • Excavate the area (typically 2 - 3 inches)
  • Rough grading begins

Day 2: Base Installation & Compaction

  • Install crushed aggregate base
  • Compact in layers for stability
  • Fine-tune grading and drainage

This is the foundation of the entire system

Day 3: Turf Layout & Seaming

  • Roll out turf and position correctly
  • Cut and shape edges
  • Seam multiple sections together

Day 4: Securing & Infill

  • Secure turf with nails approximately every 4 inches
  • Apply infill (for weight, durability, and performance); approximately 2 - 2.5 pounds per sq. ft.
  • Begin power brushing

Day 5: Final Grooming & Inspection

  • Final brush and fiber lift
  • Clean-up and detailing
  • Walkthrough and quality check
 Top

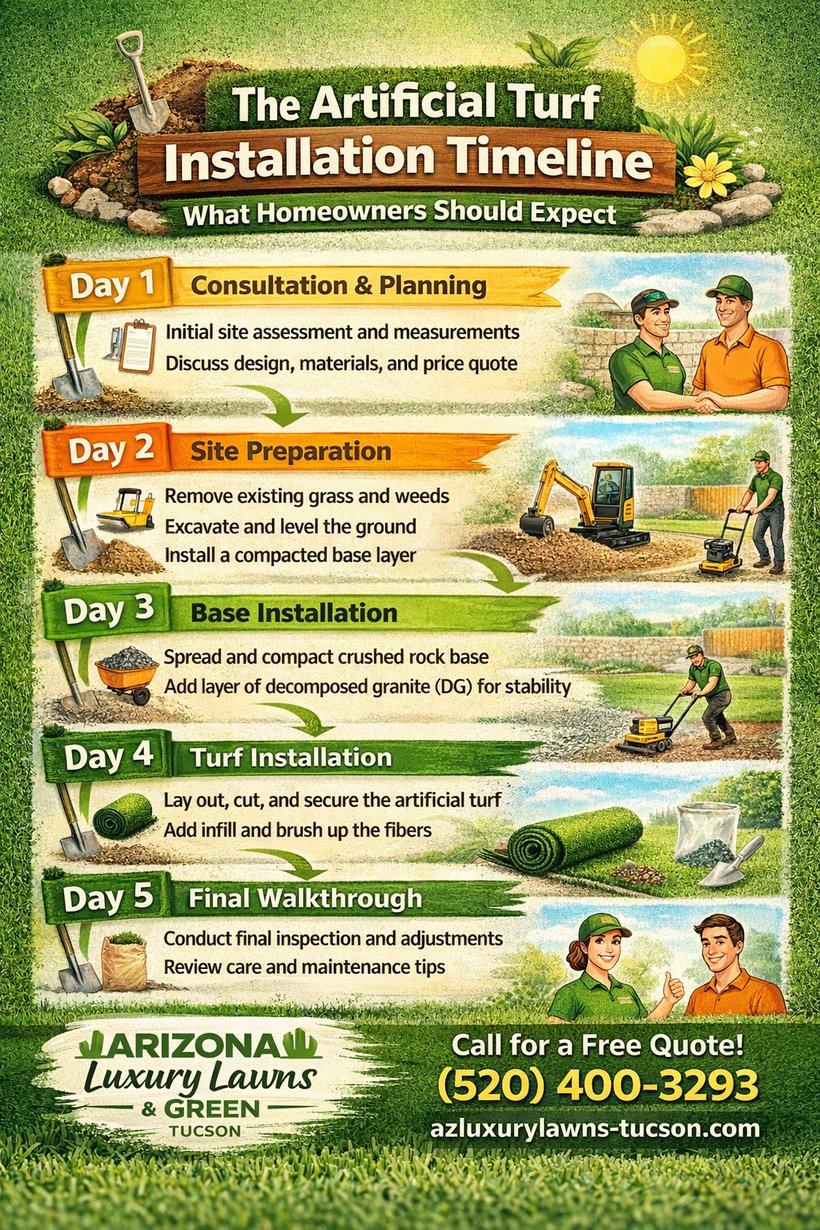

Artificial turf installation timeline in Tucson

AZsep2

Where Homeowners Get Misled

Many homeowners are told: “We can knock it out in a day.

While fast installs may sound appealing, they often skip critical steps like:

  • Proper base compaction
  • Drainage grading
  • Seam precision

That’s where long-term problems begin.

  Top
AZsep2

The Risk of Rushed Installations

Cutting corners on timeline often leads to:

  • Uneven or sinking turf
  • Poor drainage and pooling
  • Visible seams
  • Shortened lifespan

What should last 10–15+ years can fail in just a few seasons.

 Top
AZsep2

Southern Arizona-Specific Considerations

In Southern Arizona, installation timelines are influenced by:

Extreme Heat

  • Crews may adjust working hours
  • Materials behave differently in high temperatures

Soil Conditions

  • Hard desert soil requires proper excavation
  • Caliche layers may need additional preparation

Water Flow & Drainage

  • Monsoon season requires proper runoff planning
  • Poor drainage can damage both turf and surrounding areas

Artificial turf installation step

 Top
AZsep2

The Investment Mindset: Time = Quality

The biggest misconception: Faster = better. Instead, properly executed = long-term value.

A well-installed turf system:

  • Maintains appearance
  • Performs under heavy use
  • Reduces future repair costs
 Top
AZsep2

Real-World Example (Across Southern Arizona)

A 1,500 sq. ft. backyard project:

  • Day 1–2: Prep and base work
  • Day 3–4: Turf install and finishing
  • Day 5: Final detailing

Result:

  • Clean, professional finish
  • Proper drainage
  • Long-term durability
 Top
AZsep2

What Homeowners Should Ask Before Installation

Before committing to a contractor, ask:

  • How long will my project take, and why?
  • What steps are included in your process?
  • How do you ensure proper base preparation?
  • What happens if something is rushed?

The answers will tell you everything about quality and professionalism.

 Top
AZsep2

Final Thoughts: Don’t Rush the Process

Artificial turf installation is a construction project - not a quick upgrade. When done right:

When rushed:

  • It creates long-term issues
  • It reduces ROI
  • It leads to costly repairs

FAQs: Artificial Turf Installation Timeline

1. How long does artificial turf installation take in Arizona?

Most artificial turf installations throughout Tucson, Oro Valley, Marana, Sahuarita, Green Valley, Amado, Casa Grande, Florence, Eloy, Arizona City, Red Rock, Tubac, Rio Rico, Sierra Vista, Huachuca City, Benson, Vail, Corona de Tucson, Oracle, San Manuel, and surrounding communities take 2 to 5 days for standard residential projects. Larger or more complex landscapes can take up to a week or more, depending on site conditions, design complexity, and preparation requirements.

2. What is the most time-consuming part of turf installation?

The most time intensive and critical step is base preparation. This includes excavation, grading, and compacting the aggregate base. Proper base work ensures durability, drainage, and long-term performance - rushing this step can lead to costly issues later.

3. Can artificial turf be installed in one day?

While some installers may offer one-day installations, this often means cutting corners on preparation and compaction. High-quality turf installations require multiple steps to ensure proper installation, so faster is not always better when it comes to long-term results.

4. What factors can delay an artificial turf installation?

Several factors can impact the timeline, including:

  • Project size and layout complexity
  • Access to the installation area
  • Existing landscape removal
  • Weather conditions (especially extreme heat)
  • Soil conditions common in throughout Southern Arizona's surrounding communities, including Tucson, Oro Valley, Marana, Sahuarita, Green Valley, Amado, Casa Grande, Florence, Eloy, Arizona City, Red Rock, Tubac, Rio Rico, Sierra Vista, Huachuca City, Benson, Vail, Corona de Tucson, Oracle, and San Manuel

5. Does the installation timeline affect the quality of the turf?

Yes, the timeline directly impacts quality. Proper installation requires time for base compaction, precise seaming, and finishing. Rushed projects are more likely to experience issues like uneven surfaces, poor drainage, and premature wear.

The Right Timeline Starts with the Right Knowledge

Plan Your Turf Project with Confidence

Understanding the artificial turf installation timeline is just the beginning.

From cost considerations and material selection to installation quality and long-term performance, every decision you make impacts how your turf looks, performs, and lasts over time—especially in Southern Arizona’s demanding climate.

Explore our related articles to learn:

At Arizona Luxury Lawns & Greens – Tucson, we believe successful projects aren’t rushed - they’re planned, executed, and built to perform. Continue exploring and make your next step a confident one.

Best Infill for Artificial Turf? (Heat, Pets, Durability Compared)

March 20, 2026
What Is the Best Infill for Artificial Turf? | What Is Infill & Why Does It Matter? | Why Infill Selection Matters More...

Professional Artificial Turf Installation Standards in Arizona

March 5, 2026
Why Proper Installation Is the Foundation of Every Turf Project| An Outdoor Construction System | Proper Excavation |...

HOA Approval Tips for Artificial Turf in Tucson and Southern Arizona

March 19, 2026
HOA Approval Tips for Artificial Turf: What Homeowners Need to Know | The Good News: Arizona Law Is on Your Side |...
Know the Timeline. Get the Results Done Right.

Start Your Turf Project with a Plan - Not a Guess

Artificial turf installation isn’t just about how fast a project gets done; it’s about how well it’s done.

From proper base preparation and drainage to precision installation and finishing, every step in the timeline plays a critical role in how your turf performs for years to come. The difference between a smooth, long-lasting result and a costly redo often comes down to choosing the right team and the right process from the start.
